Finland Data Center Market Size and Share
Finland Data Center Market Analysis by Mordor Intelligence

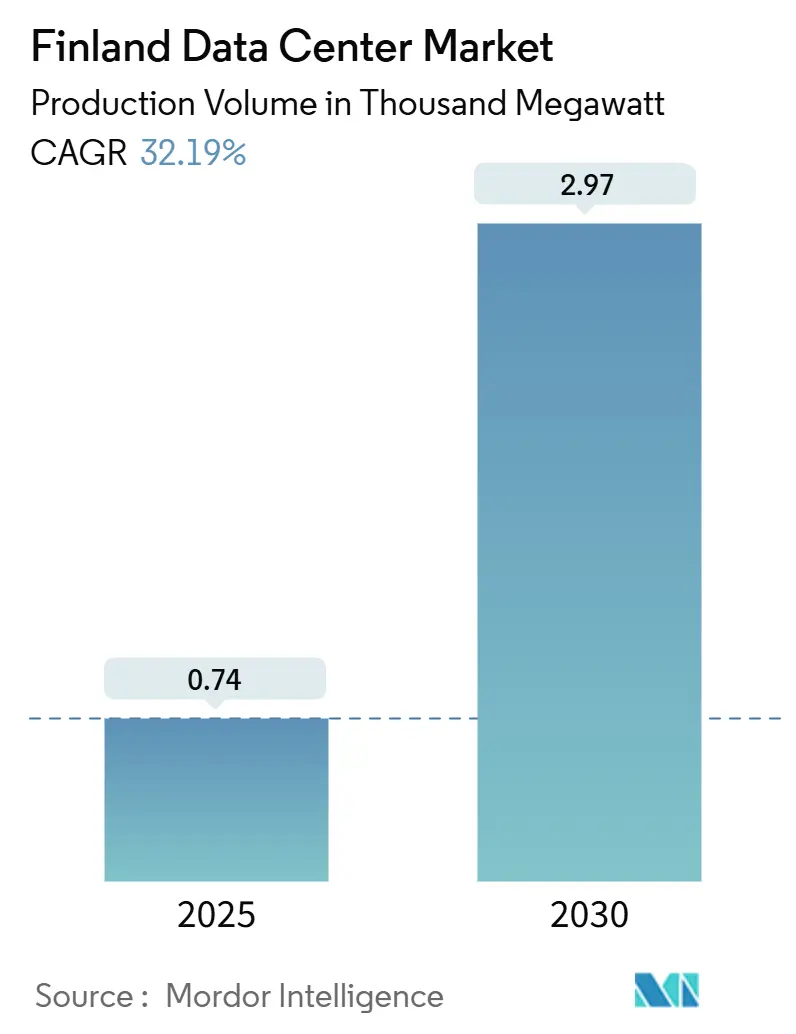

Finland’s data center market size stands at 0.79 GW of year-end installed IT load in 2026, is estimated to reach 1.91 GW in 2027, and is forecast to expand to 11.57 GW by 2032, at a 43.37% CAGR during 2027-2032. Its annual lease-equivalent value of installed IT capacity is USD 920 million in 2026, is estimated at USD 2.53 billion in 2027, and is forecast to reach USD 21.41 billion in 2032, at a 53.28% CAGR during 2027-2032.
Installed capacity is estimated to more than double in 2027, because 1,128.1 MW of additional IT load is expected to enter service during the year. Value is estimated to rise from USD 920 million to USD 2.53 billion as that capacity arrives, with the implied annual lease-equivalent rate moving from approximately USD 1.17 million to USD 1.32 million per MW. Mordor Intelligence’s Data Center Intelligence (DCI) Platform identifies campus commissioning as the main source of the capacity increase. Microsoft’s construction update, Nebius’s Lappeenranta announcement and CSC’s Kajaani update, all published in 2026, independently place new Finnish capacity around or during 2027. Commissioning dates are therefore the main swing factor in the 2027 estimate.
Finland’s expansion pairs rising occupancy with a shift in technical requirements. DCI puts utilization of year-end installed IT capacity at 83.0% in 2026 and estimates 84.5% for 2027, even as available capacity grows. MW-weighted rack density is 14.57 kW per rack in 2026 and is forecast to reach 50.03 kW by 2032, which makes high-density data center capacity the direction of the build-out. Demand for higher-capacity electrical distribution, liquid cooling and on-time commissioning of leased halls grows alongside the number of buildings, which widens the opportunity for data center suppliers in Finland.
Key Report Takeaways
- Hyperscale facilities are estimated to command 95.22% of the Finland data center market share in 2027 and are forecast to grow fastest among size classes, at a 44.38% CAGR during 2027-2032.
- Fault-tolerant tier 4 facilities are expected to represent 65.66% of the Finland data center market size in 2027, with their installed capacity forecast to grow at a 48.56% CAGR during 2027-2032.
- Colocation’s estimated 85.60% share of installed capacity in 2027, alongside its forecast 47.11% CAGR during 2027-2032, makes leased campuses the principal delivery channel for expansion.
- IT and IT-enabled services are expected to account for 66.32% of installed capacity in 2027 and lead end-user growth at a forecast 47.35% CAGR during 2027-2032.
- The Helsinki region is estimated to hold 10.45% of installed capacity in 2027 and grow at a forecast 26.79% CAGR during 2027-2032, while larger regional campuses expand faster.
- Uusimaa leads the geographic assessment with an estimated 23.0% share of installed capacity in 2027, while Central Finland starts from 0.2% and has the fastest forecast expansion among regions with a positive starting base.
- DCI identifies 5,144 MW under construction in 2026 against 543.5 MW already operational, making commissioning schedules the central supply-side risk.
Note: Market numbers in this report are based on Mordor Intelligence's proprietary estimation framework, which combines nine months of actuals with Q4 projections for base year 2026.
Market Trends and Insights
Baseline growth in installed IT capacity is 1.29% annually, supported by economic activity, expanding digital workloads, and continuing infrastructure replacement. The value baseline also includes rising annual capacity rates. Market forces together lift capacity growth by 42.08 percentage points to the forecast 43.37% CAGR during 2027-2032. Each impact below adds to or takes from baseline growth, with smaller forces and changes in the market mix accounting for the remaining balance.
Drivers Impact Analysis of Finland Data Center Market*
| Driver | (~) % Impact on CAGR Forecast | Geographic Relevance | Impact Timeline |
|---|---|---|---|
| Hyperscaler campuses already committed in Finland | +14.9% | Southern Finland, Hamina, western and northern campus locations | Medium term (2-4 years) |
| AI compute campuses backed by anchor tenants | +13.5% | Lappeenranta, Mikkeli, Seinäjoki and regional campuses | Medium term (2-4 years) |
| Signed grid connections for data centers and funded transmission build-out | +11.9% | Nationwide, especially western and northern Finland | Medium term (2-4 years) |
| Low wholesale power price and long-term clean contracts | +7.9% | Nationwide | Long term (≥ 4 years) |
| District-heating heat reuse built into campus design | +3.0% | Helsinki region and regional district-heating networks | Medium term (2-4 years) |
| EU AI factory build-out and pending gigafactory selection | +1.7% | Kajaani, Oulu and proposed consortium locations | Medium term (2-4 years) |
| Source: Mordor Intelligence | |||
Hyperscaler Campuses Already Committed in Finland
Committed hyperscaler campuses create a multi-phase construction market, with demand extending beyond each first building. Microsoft confirmed in 2026 its decision to proceed with the second construction phase of its Espoo, Kirkkonummi and Vihti region campus, while first-phase construction was nearing completion around the turn of 2026-2027. Microsoft also announced a preliminary agreement for about 190 hectares in Vaasa and Mustasaari in 2026. Repeat phases and added locations give data center construction suppliers openings in the established southern clusters and in emerging western campuses.
AI Compute Campuses Backed by Anchor Tenants
Anchor-tenant commitments, meaning contracts from large customers that underpin a project, are helping regional AI campuses move into construction. Cerebras and Compute Nordic announced a 7-year capacity agreement for a Mikkeli campus in 2026, with an initial 50 MW section under construction and a longer-term expansion path to 165 MW. Pure Data Centres stated in 2026 that the first phase of its Seinäjoki AI campus was fully leased, with power and key infrastructure secured. Such contracts support phased financing and equipment orders before a whole campus is finished, which speeds up regional AI capacity at Mikkeli and Seinäjoki.
Signed Grid Connections for Data Centers and Funded Transmission Build-Out
Signed electricity connections give projects a stronger route to delivery, although campus construction still takes several years. Fingrid reported that data center projects with signed connection agreements exceeded 5 GW of planned final electrical capacity by October 2026, including projects connected through distribution networks.[1] Fingrid also made an investment decision in 2026 on the approximately 350 km Metsälinja 2 transmission connection between Vaala and Jämsä, targeted for service in 2030. Contracted connections support near-term construction, while transmission reinforcement widens the locations available for later phases in western and northern Finland.
Restraints Impact Analysis of Finland Data Center Market*
| Restraint | (~) % Impact on CAGR Forecast | Geographic Relevance | Impact Timeline |
|---|---|---|---|
| Draft grid-queue priority law ranking data centers low | -3.1% | Nationwide, with greater exposure for large uncontracted projects | Medium term (2-4 years) |
| Announced pipeline running far ahead of financed and leased capacity | -4.7% | Nationwide, especially greenfield regional campuses | Medium term (2-4 years) |
| Data-center electricity tax raised to the general class | -1.1% | Nationwide | Short term (≤ 2 years) |
| Construction labor and electrical trades stretched by simultaneous builds | -1.9% | Nationwide, particularly regional construction clusters | Medium term (2-4 years) |
| Source: Mordor Intelligence | |||
Announced Pipeline Running Far Ahead of Financed and Leased Capacity
Finland’s announced development pipeline holds projects at very different stages of commercial readiness. SSS reported in 2026 that Regant’s 250 MW Salo project was permitted and grid-contracted but still awaiting an investment decision. Pure Data Centres’ Seinäjoki announcement in 2026, by contrast, described a fully leased first phase. Tenant commitments and financing milestones signal delivery more reliably than total announced campus capacity, which is why this restraint weighs most on greenfield regional campuses.
Permitting also moves delivery dates after a project has drawn market attention. Yle reported in 2026 that FCDC’s Rovaniemi project still required zoning, environmental assessment and permits, with an investment decision possibly several years away. Yle also reported that Bitzero’s Kokemäki development depended on a new power connection after the developer dropped its smaller pilot concept. Regional supply arrives unevenly, so the announced commissioning years of campuses such as Rovaniemi and Kokemäki carry more risk until land, electricity, finance and tenants are secured together.
Draft Grid-Queue Priority Law Ranking Data Centers Low
Finland’s draft grid-queue priority law raises scheduling risk for large projects without binding connection agreements. HPP Attorneys’ 2026 assessment placed data centers above 10 MW in the draft’s third priority group, with larger applications handled in batches. Yle reported in November 2026 that the proposal had missed its parliamentary submission timetable and that its intended start date was likely to move. The open question is how and when uncontracted applications will be treated, and large uncontracted campuses carry the most exposure.
Developers are already adjusting investment preparation to the draft rules. Reporting based on Yle and Karjalainen in November 2026 described Scale42’s 60 MW Kitee project as paused because its connection assessment could be deferred. Liperi municipality warned in October 2026 that the proposal could delay another Scale42 development in eastern Finland. Campuses with signed connections hold a timing advantage over comparable sites still awaiting allocation.
*Our forecasts treat driver/restraint impacts as directional, not additive. The impact forecasts reflect baseline growth, mix effects, and variable interactions.
Finland Data Center Market Segment Analysis
By Data Center Size:

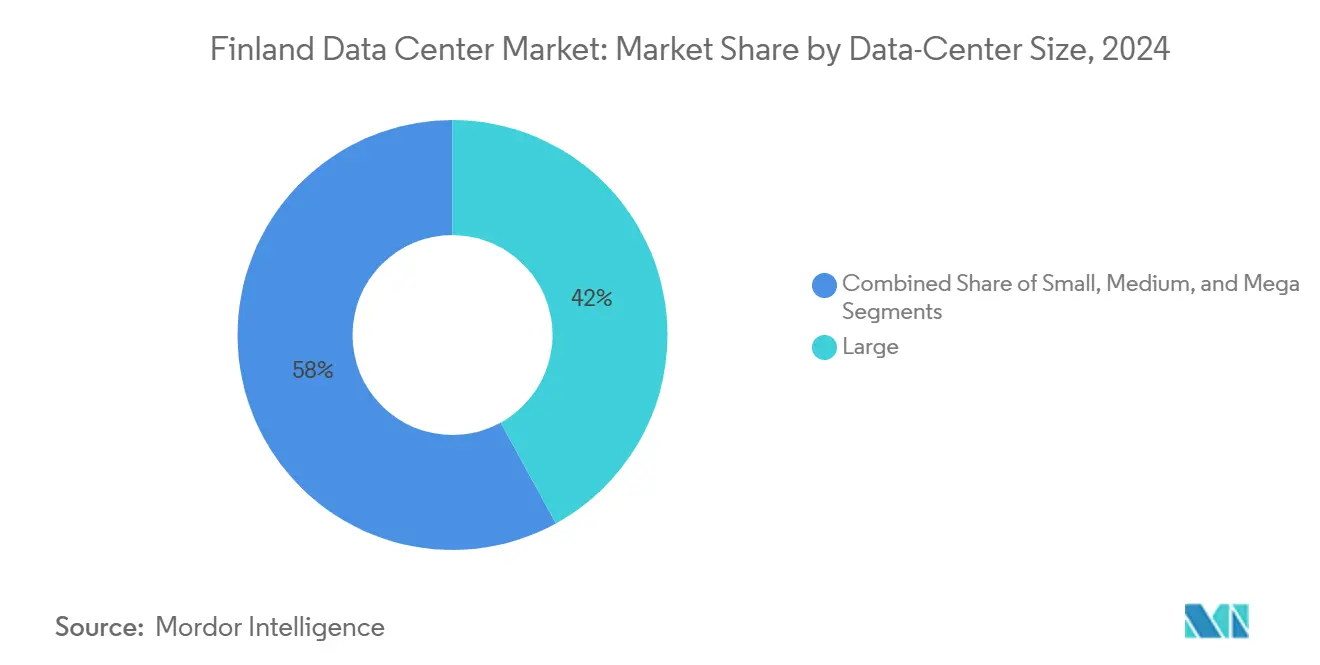

Campus-Scale Supply Sets the DirectionHyperscale facilities, the very large campuses built for cloud and AI tenants, are estimated to capture 95.22% of the Finland data center market size in 2027 and are forecast to expand at a 44.38% CAGR during 2027-2032. DCI identifies virtually all capacity under construction in 2026 as campus-scale supply. Microsoft’s multi-campus program and Pure Data Centres’ phased Seinäjoki development show why large cloud and AI buyers favor sites that can take successive halls. Scale lets those buyers expand without repeating the full land and grid-development process, so hyperscale data center campuses set the growth path for the whole market.
Medium facilities keep a role in smaller deployments and are forecast to grow steadily, though far more slowly than hyperscale. Equinix’s 2025 announcement of Groq’s European inference deployment in Helsinki points to demand for computing close to connected metropolitan infrastructure. Large and small facility classes hold flat capacity paths because most additional megawatts go to hyperscale campuses. A hyperscale-sized building can still run as colocation, since size class follows facility scale. Medium and metropolitan sites therefore serve inference and enterprise needs while campuses take the volume.
By Tier Type:
Fault Tolerance Gains WeightTier ratings grade how well a facility keeps running during repairs or failures, and tier 4 is expected to account for 65.66% of the Finland data center market share in 2027. Its installed capacity is forecast to increase at a 48.56% CAGR during 2027-2032. DCI places the largest forthcoming campuses in the fault-tolerant category, where duplicated infrastructure limits the effect of equipment failures. Dense computing installations make continuity of power and cooling commercially important because one interruption affects more computing capacity. Fault-tolerant design is becoming the standard for Finland’s largest AI and cloud campuses.
Tier 3, the second-largest tier, covers facilities designed for maintenance without interrupting service, and it is forecast to grow more slowly than tier 4. Telia’s 2026 discussion of its Helsinki operations described customers spanning banks, public administration, healthcare and liquid-cooled neocloud (specialist AI cloud) deployments. Those workloads sustain demand for maintainable infrastructure alongside larger fault-tolerant campuses. Tier 1 and 2 facilities hold a much smaller position and mainly serve less demanding enterprise and regional needs, so tier 3 space remains the main option for mixed Helsinki customers.
By Data Center Type:
Colocation Carries the ExpansionColocation, which means renting space in a facility run by a provider, is estimated to represent 85.60% of installed capacity in 2027 and is forecast to grow at a 47.11% CAGR during 2027-2032. Pure Data Centres’ preleased Seinäjoki phase and Glesys’s 2026 agreement with Trevian for Campus Oulu show two versions of the leased-campus model. Wholesale tenants can secure dedicated halls, while smaller deployments use racks, cages or suites. Demand in the data center colocation market includes hyperscale build-to-suit leases, which are halls built to a tenant’s specification, as well as metropolitan retail services. Leased campuses therefore carry most of Finland’s new capacity.
Enterprise and edge capacity, owned and run by enterprises, governments and telecoms, is forecast to contract slightly during 2027-2032 as new supply concentrates in leased campuses. Cloud-provider self-built capacity forms a separate category, and Google’s own campuses belong to it. A cloud company that leases a hall counts as a colocation occupier. Owner-operated enterprise sites are the part of the market giving ground to leased campuses.
By End User:
IT Services Lead, With Distinct Secondary WorkloadsIT and IT-enabled services, which cover cloud platforms and software and IT services companies, are expected to account for 66.32% of installed capacity in 2027 and grow at a forecast 47.35% CAGR during 2027-2032. Nebius’s dedicated Finnish AI infrastructure and Cerebras’s Mikkeli agreement reflect demand from companies selling computing and software services to other organizations. Their requirements combine accelerator-ready halls with assured power, cooling and expansion rights. Sales of computing services to outside customers, and not only internal cloud workloads, underpin the IT services lead.
Media and entertainment is the second-largest end-user group and is forecast to grow second fastest during 2027-2032. TikTok’s 2026 announcement confirmed an additional Finnish development in Lahti and a signed main-tenant agreement, which adds a separate demand pool for large-scale data storage and platform infrastructure. Government demand includes publicly backed computing, while BFSI (banks, insurers and payment firms) includes financial institutions’ own deployments. Manufacturing, telecom, e-commerce and other occupiers add a broader enterprise base but remain smaller than IT services. Platform operators such as TikTok give media a growth path separate from cloud demand.
By Hotspot:
Helsinki Keeps Connected Demand While Regional Campuses ScaleThe Helsinki region is estimated to hold 10.45% of installed capacity in 2027 and is forecast to grow at a 26.79% CAGR during 2027-2032. Equinix’s Finnish infrastructure connects enterprise customers to cloud platforms, while Verne’s 2025 Helsinki expansion announcement specified new buildings supporting liquid cooling. Those investments favor workloads that value network access and proximity to existing customers. Helsinki data center capacity keeps a distinct commercial role in connected services even as its relative weight declines.
Capacity elsewhere in Finland expands faster as developers assemble larger land and power positions. DCI identifies major construction programs around Vaasa, Seinäjoki, Pori and Lappeenranta, while atNorth’s 2026 Salo announcement added another phased regional campus. Buyers can place large training and batch-computing workloads outside the capital and keep metropolitan infrastructure for connected services. Regional growth broadens the opportunity for suppliers beyond Helsinki-based construction and operating teams.
Geography Analysis
Uusimaa: The Largest Regional Base
Uusimaa is estimated to account for 23.0% of the Finland data center market share in 2027. DCI forecasts its installed capacity reaching 496 MW by 2032, with the region losing relative weight as larger developments elsewhere enter service. Microsoft’s southern campuses, Hyperco’s Lohja development and established Helsinki-area operators support a diverse customer base. Helsinki’s 2026 siting principles also made electricity availability, environmental effects and heat use explicit considerations for future development. Uusimaa remains the base for connected enterprise and cloud customers, with new growth shifting to other regions.
Finland Data Center Market, Selected Regional Market Shares (2027)
| Region | Share of installed IT capacity |
|---|---|
| Uusimaa | 23.0% |
| Central Finland | 0.2% |
| Source: DCI | |
Central Finland: The Fastest Expansion From a Small Base
Central Finland has the fastest forecast capacity growth among regions with a positive 2027 starting base. Its estimated 0.2% share in 2027 precedes a forecast increase to 1,534.2 MW by 2032, according to DCI. Sesterce’s announced Jämsä campus brings a former paper-mill site into the development pipeline, while Keuruu began zoning a separate wind, solar and data center area in 2026. Delivery in Jämsä and Keuruu depends on converting large industrial land positions into permitted, connected and commercially committed phases.
Satakunta and Ostrobothnia: Construction Moves West
Satakunta’s development combines Pori’s industrial sites with Kokemäki’s larger campus ambitions. DCI identifies 1,605 MW under construction in Satakunta in 2026, and NCC announced the start of preparatory construction for ASP DC Pori in 2026. The western cluster also benefits from proximity to generation, which Fingrid’s 2026 siting study identified as a way to improve connection availability. Satakunta moves into the leading regional group by 2032 as those phases are commissioned.
Vaasa’s GigaVaasa area brings together large industrial plots and several competing developers. DCI identifies FCDC’s Vaasa campus as the largest individual project in the construction pipeline, while Microsoft progressed a separate Vaasa-Mustasaari site during 2026. Yle reported that Mustasaari granted Microsoft a building permit in 2026. Vaasa’s appeal rests on several developments at once, although each campus keeps its own connection and permitting timetable.
Kainuu, Lapland, and North Ostrobothnia: Different Routes to Growth
Kajaani’s position rests on established scientific computing and added private investment. DCI places Kainuu among the largest regional bases in 2027, while YIT’s 2026 announcement confirmed fit-out and building-services work for another XTX Markets building. In Lapland, the Rovaniemi development faces a longer preconstruction path, including groundwater-related studies described by Yle in 2026. Northern Finland combines an established computing cluster in Kainuu with Lapland projects whose physical delivery is further away.
North Ostrobothnia is building a broader commercial campus base around Oulu. DCI identifies 382 MW under construction in the region in 2026, while Glesys and Trevian’s Campus Oulu agreement provides a phased route from an initial deployment to a larger site. The AIGF Northern consortium announced in 2026 also included an intended Oulu location, subject to its planned European bid. Oulu’s opportunity spans commercial colocation and prospective public compute procurement, each with a different funding route.
Competitive Landscape
Market Concentration
FCDC is the leading operator in DCI’s 2027 outlook, with an estimated 17.4% share of installed capacity. FCDC describes its business as developing large, power-secured Finnish projects for hyperscale and AI operators. Its Vaasa construction program supports its longer-term position, while its 2027 share rests on Rovaniemi, which DCI lists for 2027 commissioning but which is still in permitting. FCDC’s rank is consequently linked to the conversion of development capacity into commissioned operating sites.
The 3 leading operators, FCDC, CSC, and Hyperco, together are estimated to hold 39.5% of installed capacity in 2027. CSC ranks second through its established scientific-computing base, while Hyperco ranks third ahead of Polarnode and ByteDance. Verne, Pure Data Centres, Nebius, and atNorth pursue expansion through different combinations of operating campuses, leased phases, and new regional construction. Competition centers on secured electricity, funded construction, and on-time delivery of high-density capacity.
Nebius’s disclosures show how AI infrastructure companies are widening the competitive field. Its first-quarter 2026 shareholder letter described the new Lappeenranta location as a 310 MW development when fully deployed, and its third-quarter 2026 letter kept both Lappeenranta and a second Mäntsälä site in its 2027 deployment schedule. Owned, accelerator-ready infrastructure of this kind ties Finnish capacity growth to data center server market demand. Equinix and CPP Investments’ announced acquisition of atNorth in 2026 showed the attraction of Nordic development platforms to larger capital providers, who are now entering Finland’s competitive field.
Finland Data Center Industry Leaders
-
FCDC Corp Oy
-
CSC – IT Center for Science
-
Hyperco Oy
-
Polarnode Oy
-
ByteDance
- *Disclaimer: Major Players sorted in no particular order
Finland Data Center Market Companies Covered in this Report
- FCDC Corp Oy
- CSC – IT Center for Science
- Hyperco Oy
- Polarnode Oy
- Bytedance Ltd
- Verne Global ehf
- Pure Data Centres Group Limited
- Nebius B.V.
- Pyhäsalmen Kvanttikiinteistöt Oy
- Bilt Tek
- Arcem, Inc.
- Compute Nordic Ltd.
- Bitzero Blockchain Inc.
- Suomen Energiainsinoorit Technology Oy
- atNorth
- Sesterce Group
- DayOne Data Centers Singapore Pte. Ltd.
- Scale42 AS
- Glesys AB
- Trevian Asset Management oy
Finland Data Center Capacity Build Up
Finland’s supply still to come is far larger than the capacity operating today. DCI identifies 543.5 MW operational in 2026, alongside 5,144 MW under construction and 5,228.8 MW announced for delivery by 2032. Under-construction capacity alone is about 9.5 times the operational base, so supply arrives in campus-sized phases. The 0.79 GW market size in 2026 sits above operational capacity because it includes projects due for commissioning by year end. The final forecast years also rely on further projects beyond those identified, so later development decisions weigh on the 2032 outlook.
The further capacity expected by 2032 is Mordor Intelligence's forecast beyond the projects DCI lists, accounting for projects not announced yet.
Finland Data Center Market, 2032 Capacity Outlook (Total 11.57 GW in 2032)
| 2026 Status | Projects | IT load by 2032 (GW) | Share of 2032 MW |
|---|---|---|---|
| Operational | 38 | 0.54 | 4.7% |
| Under Construction | 28 | 5.14 | 44.5% |
| Announced | 33 | 5.23 | 45.2% |
| Planned | 22 | 0.00 | 0.0% |
| Further capacity expected by 2032 | - | 0.65 | 5.6% |
| Total (2032) | 121 | 11.57 | 100.0% |
| Source: DCI | |||
Finland Data Center: Under Construction and Announced Capacity
FCDC leads capacity under construction in 2026, with 1,534.5 MW, ahead of Bitzero at 533.3 MW and Pure Data Centres at 440.4 MW. Across their identified facilities, those construction programs contribute to expected 2032 IT loads of 1,601.1 MW, 533.3 MW, and 440.4 MW, respectively. atNorth follows with 399.9 MW under construction and expected installed IT load of 565.2 MW by 2032, while Nebius has 358.5 MW under construction and 489 MW expected by 2032. The build-out gives regional developers and AI-focused operators a larger role alongside established metropolitan providers.
AI-ready facilities account for 71.0% of operational IT load in 2026, compared with 89.7% under construction and 59.5% announced. The corresponding counts are 7 of 38 operational facilities, 20 of 28 under construction, and 27 of 33 announced, with none of the 22 planned facilities flagged AI-ready. DCI measures rack density at 54.86 kW per rack for construction-stage facilities against 10.99 kW for facilities already commissioned. The commissioned figure sits below the 14.57 kW year-end average for 2026 because that average includes projects due by year end. Denser racks, predominantly hyperscale buildings, regional locations and colocation-led construction make purpose-built AI infrastructure the main delivery requirement.
Finland Data Center Market, Largest Under-Construction and Announced Projects
| Project | Operator | Place | Status | IT load (MW) | Expected Commissioning | AI Readiness | Short description |
|---|---|---|---|---|---|---|---|
| FCDC Vaasa | FCDC | Vaasa, Ostrobothnia | Under Construction | 1,278.76 | 2029 | AI-ready | Developer FCDC is building a two-building data center campus in the GigaVaasa area for an undisclosed operator. |
| Sesterce Campus Jämsä | Sesterce | Jämsä, Central Finland | Announced | 562.60 | 2029 | - | Renewable-powered AI campus built on the former Kaipola paper mill site for an anchor AI customer. |
| Bitzero Kokemäki | Bitzero | Kokemäki, Satakunta | Under Construction | 533.30 | 2030 | AI-ready | Bitzero's Kokemäki data center campus is being developed to serve hyperscale, AI and high-performance computing customers. |
| Klaukkala Data Center DC1 | DayOne | Klaukkala, Uusimaa | Announced | 455.28 | 2029 | AI-ready | A planned hyperscale data center campus in Klaukkala that DayOne will lease to cloud and enterprise customers. |
| Arcem Joroinen Phase 3 | Arcem | Joroinen, North Savo | Announced | 400.00 | 2032 | AI-ready | Data center campus site beside Fingrid's Huutokoski substation, serving AI, hyperscale and regional customers. |
| Source: DCI | |||||||
Water and Electricity Scenario
Electricity demand in Finland’s data centers expands with both occupied IT capacity and the infrastructure that supports it. DCI estimates facility power at utilized load at 841 MW for year-end 2026, an estimated 2,086 MW in 2027 and a forecast 13,223 MW in 2032, at a constant PUE of 1.29. PUE, or power usage effectiveness, measures total facility electricity relative to IT electricity. Continuous operation at the 2026 load would imply an upper bound of 7.4 TWh annually, with actual use lower because equipment rarely draws its full rated load throughout the year. Facility power rises roughly in step with installed capacity, which makes electricity supply a central physical requirement for Finland’s growth.
Grid access in Finland varies by location and by whether a binding connection already exists. Fingrid’s 2026 update said new capacity was almost fully reserved in several areas, while parts of northern Finland could still connect new demand more quickly. Fingrid’s 2026 siting study found that more than 70% of generation was located on the west coast and in northern Finland, while more than 50% of consumption was in the south. Energy Authority figures also imply an 89.18% increase in Finland’s average wholesale electricity price in the first quarter of 2026 compared with the same period of 2025, which raises the value of long-term clean power contracts. Well-sited campuses with such contracts hold the advantage, and demand in the data center power market strengthens for substations, backup systems, and controllable loads.
Cooling-water requirements depend on the chosen system and local utility conditions. Nebius’s 2026 Lappeenranta announcement described closed-loop cooling, while Verne’s Helsinki expansion announcement specified liquid-cooling support and heat recovery. The Finnish Water Utilities Association’s 2026 guidance emphasized early coordination on average and peak water requirements across construction and operating phases. Rovaniemi’s groundwater-related studies show that local environmental conditions still affect permitting even where cooling systems limit routine freshwater use, so water planning is part of site selection for northern campuses.
Historical Series
Finland’s installed capacity grew gradually before the current campus-construction cycle. DCI’s historical series shows no additions in 2022 or 2023, followed by additions in 2024 and 2025. Utilized capacity rose across the same period, so existing facilities absorbed demand before larger developments began to enter service. Forecast delivery is on a different scale, which gives commissioning dates more weight in Finland than they had in the earlier series.

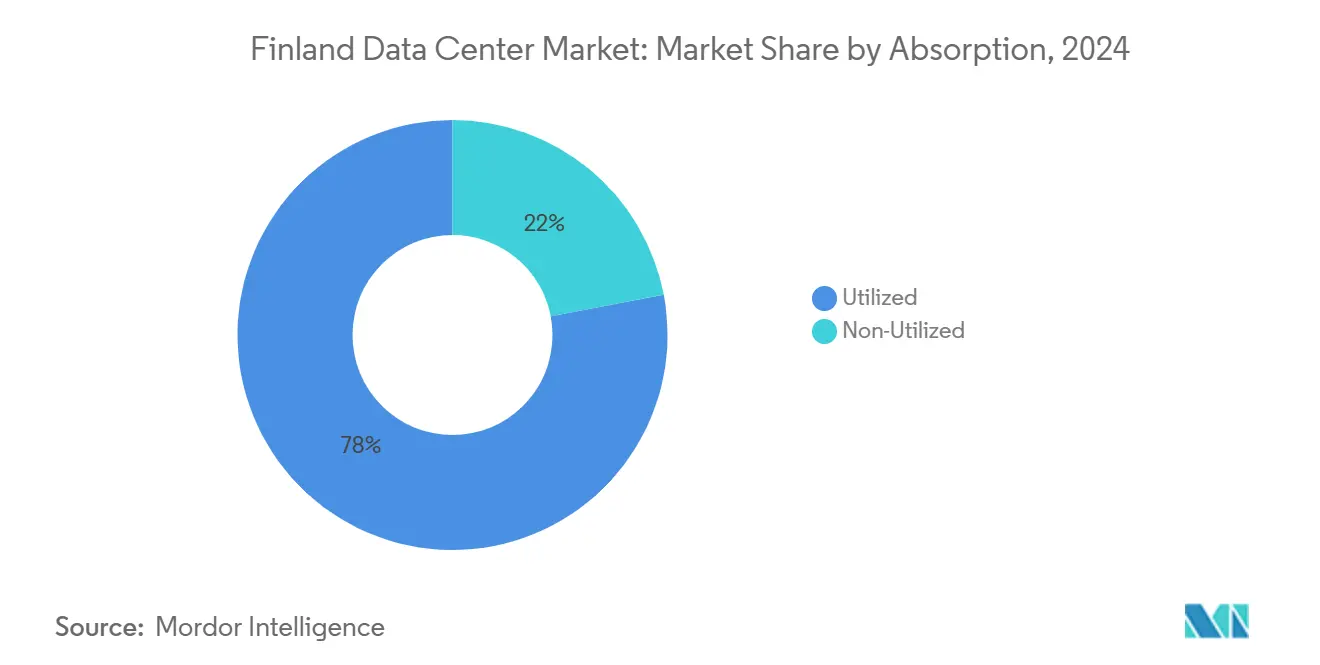

New capacity filled quickly in the latest completed year. Utilized capacity rose by 59.9 MW during 2025, against a 64 MW increase in installed capacity, so nearly all added megawatts were taken up. Utilization consequently rose from 80.1% in 2024 to 81.6% in 2025. This record supports phased expansion in Finland, and the much larger forthcoming campuses need correspondingly larger tenant commitments.
Finland Data Center Market, Historical Installed and Utilized IT Capacity (2021-2025)
| Year | Installed IT load (MW) | Utilized IT load (MW) |
|---|---|---|
| 2021 | 515 | 391.4 |
| 2022 | 515 | 398.3 |
| 2023 | 515 | 405.4 |
| 2024 | 541 | 433.4 |
| 2025 | 604.9 | 493.3 |
| Source: DCI | ||
Construction Cost Benchmarks
Helsinki’s construction costs are rising. Turner & Townsend’s 2026-2027 index places Helsinki’s standardized construction cost at USD 13.33 per watt, compared with USD 12.3 per watt in its preceding edition.[2] That is an 8.37% increase, which on the index’s 60 MW reference design adds approximately USD 61.8 million of construction cost. Rising build costs bear directly on colocation, the channel carrying most new Finnish capacity.
Helsinki’s standardized benchmark sits above the median of USD 9.72 million per MW across Finnish project investments in DCI. Individual project budgets cover different combinations of phases, equipment, and enabling works, which accounts for the gap. The benchmark gives a procurement reference, while project-level budgets show where a proposed cost needs closer examination. Colocation suppliers that reconcile land, utility works, fit-out, and contingency before setting a lease price work from a clearer cost base.
Recent Industry Developments in Finland Data Center Market
- Nov 2026: Seinäjoki’s city board approved a preliminary agreement for approximately 85.7 hectares of additional land associated with Pure Data Centres’ campus expansion. The city said later phases remained dependent on new power-line connections.
- Oct 2026: atNorth announced FIN05 in Salo, with 75 MW of first-phase power secured and a path to a larger campus. The announcement added another regional location to its Finnish development program.
- Sep 2026: EuroHPC and CSC announced the LUMI-AI procurement contract, with deployment planned for the second half of 2027 in Kajaani’s new data center. CSC said the system would deliver a tenfold increase in AI capacity.
Finland Data Center Market Report Scope and Research Methodology
Market Definition and Coverage
The market measures installed data center IT capacity and its annual lease-equivalent value in Finland. The service is powered, cooled, and secured data center space, measured as critical IT load, whether leased from a colocation provider or built and operated by a cloud provider, enterprise, government, or telecom company for its own use. Capacity measures IT megawatts installed by year end. Value applies an annual country- and metro-specific capacity rate to those megawatts, including owner-operated facilities on the same lease-equivalent basis.
IT equipment, construction spending, and electricity bills are excluded from market value. The Finnish figures imply annual capacity values of approximately USD 1.17 million per MW in 2026 and USD 1.32 million in 2027, with the forecast rate increasing thereafter. These are provider-revenue-equivalent rates applied to installed capacity, rather than reported cash revenue collected from every facility.
Year-end capacity includes projects due to be commissioned during the stated year, including projects still under construction or announced when the research is conducted. From 2027 onward, projects enter the forecast in their expected commissioning year, and the final forecast years include additional capacity beyond listed projects. Facility size, redundancy tier, operating type, occupier industry, and location are separate classifications. A hyperscale-sized leased building is colocation, while cloud-provider-owned and operated capacity is self-built. Each facility is assigned to its operator, excluding space that the company rents within another operator’s facility.
Segments Covered in This Report
- By Data Center Size
- Hyperscale
- Large
- Medium
- Small
- By Tier Type
- Tier 1 and 2
- Tier 3
- Tier 4
- By Data Center Type
- Hyperscale / Self-built
- Colocation
- Utilized Colocation
- Retail Colocation
- Wholesale Colocation
- Non-Utilized Colocation
- Utilized Colocation
- Enterprise / Edge
- By End User
- BFSI
- IT and ITES
- E-Commerce
- Government
- Manufacturing
- Media and Entertainment
- Telecom
- Other End Users
- By Hotspot
- Helsinki Region
- Rest of Finland
Data Sources, Market Sizing, and Validation
Desk Research
Research draws on Fingrid’s connection and transmission publications, Energy Authority electricity-market statistics, Statistics Finland’s energy and economic series, Ministry of Economic Affairs and Employment policy documents, Finnish Data Center Association studies, and municipal land-use and permitting decisions. Those sources establish the physical, regulatory, and economic conditions affecting Finnish data center delivery.
Company annual and quarterly reports, investor materials, construction announcements, tenant agreements, and utility releases provide project-level evidence. DCI supplies facility-level capacity, utilization, status, density, tier, operator, and location information. These sources are not exhaustive, and further sources inform data collection, validation and clarification.
Primary Interviews and Surveys
Analysts interview data center operators, cloud and AI infrastructure buyers, developers, utilities, contractors, and power and cooling suppliers. Interviews test commissioning schedules, tenant demand, connection readiness, procurement costs, and the interpretation of public announcements. Discussions with senior executives and operating managers help reconcile commercial commitments with construction progress.
Distribution of primary research fieldwork respondents
| Company type | Respondent position | Region |
|---|---|---|
| Top tier: 35% | CXOs: 20% | Southern Finland: 45% |
| Mid tier: 50% | Functional/Unit leaders: 30% | Western Finland: 35% |
| Smaller Players: 15% | Managers: 50% | Northern and Eastern Finland: 20% |
Market-Sizing & Forecasting
Installed IT load is built facility by facility from commissioned capacity, location assessments, and expected project completion dates. The principal forecast variables are secured electricity connections, construction progress, anchor-tenant commitments, rack density, annual capacity rates, and the availability of labor and electrical equipment. Utilization provides a separate check on whether demand can absorb the installed base.
Capacity forecasting starts with baseline growth of 1.29% annually and incorporates the effects of committed hyperscale campuses, AI demand, grid infrastructure, clean power contracts, heat reuse, and European compute procurement. Grid allocation, pipeline conversion, taxation, and construction constraints reduce the resulting growth path. Value grows faster than capacity because annual lease-equivalent rates rise by 7.00% per year during the forecast period.
Segment mixes follow facility characteristics, while end-user allocation follows the tenant mix of cloud and wholesale capacity. Regional aliases are combined before geographic comparisons are made. Forecast cross-checks include electricity requirements, construction-stage capacity, utilization, public industry outlooks, and the relationship between announced campuses and contracted infrastructure. Further capacity beyond identified projects is included in the final forecast years, with commissioning timing the largest uncertainty.
Data Validation and Update Cycle
Analysts triangulate facility capacity against company disclosures, contractor milestones, permits, utility connections, and tenant announcements. Anomaly review focuses on duplicated campuses, different names for the same operator or place, electrical input capacity versus critical IT load, and full-campus announcements versus individual construction phases. Status-based operational figures are distinguished from capacity expected to be installed by year end.
The market receives an annual refresh, with interim updates following major construction decisions, cancellations, acquisitions, regulatory changes, or connection awards. Revised commissioning dates flow through the capacity outlook, utilization assessment, and associated annual value. Historical changes are reviewed alongside the forecast to maintain consistent definitions across periods.
Comparison With Published Estimates
Specialist Intelligence Provider A measures live supply during the year, while this report measures capacity installed by year end. The earlier cutoff explains part of the lower estimate because projects scheduled for subsequent commissioning enter this report’s annual total. Different facility coverage and treatment of critical IT load account for the remaining difference. The estimates should therefore be compared first by operating date and facility perimeter.
Comparison With Published Estimates
| Publisher | Market Size | Key gap |
|---|---|---|
| Mordor Intelligence | 0.79 GW in 2026 | Installed IT capacity at year end, including capacity due to be commissioned during the year |
| Specialist Intelligence Provider A | Approximately 0.40 GW in July 2026 | Live supply at the interview date, before the year-end commissioning cutoff |
| Industry Tracker B | 0.15 GW in October 2026 | Live capacity across 8 of 21 tracked facilities publishing a megawatt figure |
Industry Tracker B measures a disclosure-limited live-capacity total, covering only facilities with published megawatt information. Its smaller figure follows from both that restricted coverage and the exclusion of capacity still due to enter service during the year. Neither external capacity estimate requires a revenue-chain or currency adjustment. The practical comparison is between a partial live-supply reading and a year-end installed-capacity assessment.
Key Questions Answered in the Report
What is the Finland data center market size?
The Finland data center market size is 0.79 GW of year-end installed IT load in 2026. Capacity is estimated at 1.91 GW in 2027 and forecast to reach 11.57 GW by 2032.
Is Finland developing high-density data centers?
Yes. DCI measures MW-weighted rack density at 14.57 kW per rack in 2026 and forecasts 50.03 kW by 2032. Construction-stage facilities have higher density than facilities already commissioned.
Which companies lead Finland’s data center market?
DCI’s estimated 2027 ranking places FCDC first, followed by CSC, Hyperco, Polarnode, and ByteDance. The 3 leading operators together account for an estimated 39.5% of installed capacity.
What is Helsinki’s role in Finland’s data center industry?
Helsinki and its surrounding region support connected enterprise, cloud-access, and colocation workloads. The Helsinki region is estimated to hold 10.45% of installed capacity in 2027, while larger regional campuses drive faster national expansion.
What opportunities exist for data center suppliers in Finland?
DCI identifies 5,144 MW under construction in 2026. The projects create demand for electrical infrastructure, cooling, cabling, construction, controls, and commissioning services, with contract timing tied to each campus phase.
Which are the largest data center projects in Finland?
The largest projects under construction or announced are FCDC’s Vaasa campus (1,278.8 MW, expected 2029), Sesterce’s Jämsä campus (562.6 MW, 2029), Bitzero’s Kokemäki campus (533.3 MW, 2030), DayOne’s Klaukkala campus (455.3 MW, 2029), and Arcem’s Joroinen Phase 3 (400 MW, 2032). Vaasa is the largest single project.
- Artificial Intelligence (AI) Data Center Market AI facilities across the global market, covering facility type, component and tier.
- Data Center Construction Market Construction worldwide, split by tier, facility size and facility type.
- Data Center Cooling Market Cooling across the global market, covering cooling technology, cooling component and facility type.
- Sweden Data Center Rack Market Sweden's racks, split by rack size, rack height and rack type.
- Denmark Data Center Storage Market Storage in Denmark, split by facility size and tier.
- United States Multi-Tenant (Colocation) Data Center Market The US's colocation, split by solution type, tier and facility size.
- United States Data Center Construction Market Construction in the US, split by tier, facility size and facility type.
